gantt charts#

This section describes various options available for gantt charts in fivecentplots

See the full API

Warning

Gantt charts are only currently available when using the mpl plotting engine

Setup#

Import packages:


import fivecentplots as fcp
import pandas as pd
from pathlib import Path
import datetime

Optionally set the design theme (skipping here and using default):


fcp.set_theme('gray')
# fcp.set_theme('white')
Previous theme file found! Renaming to "defaults_old.py" and copying theme "gray"...done!

Basic chart#

The simplest Gantt chart available in fivecentplots is essentially a horizontal bar chart in which each row represents a task and the bar length represents a data range. Gantt charts support all fivecentplots grouping options to enable deeper insight into work tasks.

The following arguments are required to generate a Gantt chart:

  • df: a pandas.DataFrame containing date-bound tasks

  • x: two column names:

    1. the start date column name

    2. the end date column name

  • y: a task name

The input DataFrame can come from a csv file, an excel sheet, or even manually via a StringIO object as shown in the example below.


from io import StringIO
gantt_data = StringIO(
"""
Task,Assigned,Start,Stop,Category
Record drums,Taylor,2010-09-01,2010-09-05,Recording
Record bass,Nate,2010-09-04,2010-09-06,Recording
Record rhythm guitar,Pat,2010-09-06,2010-09-08,Recording
Record rhythm guitar,Dave,2010-09-06,2010-09-08,Recording
Record lead guitar,Chris,2010-09-07,2010-09-09,Recording
Record keys,Rami,2010-09-07,2010-09-09,Recording
Record lead vocals,Dave,2010-09-09,2010-09-11,Recording
Record backup vocals,Chris,2010-09-11,2010-09-12,Recording
Record backup vocals,Taylor,2010-09-11,2010-09-12,Recording
Guitar overdubs,Pat,2010-09-11,2010-09-12,Recording
Guitar overdubs,Chris,2010-09-11,2010-09-12,Recording
Production,Butch,2010-09-12,2010-09-16,Post
Mixing,Alan,2010-09-16,2010-09-20,Post
Mastering,Joe,2010-09-21,2010-09-25,Post
Mastering,Emily,2010-09-21,2010-09-25,Post
"""
)
df_basic = pd.read_csv(gantt_data)
df_basic.head()

Task Assigned Start Stop Category
0 Record drums Taylor 2010-09-01 2010-09-05 Recording
1 Record bass Nate 2010-09-04 2010-09-06 Recording
2 Record rhythm guitar Pat 2010-09-06 2010-09-08 Recording
3 Record rhythm guitar Dave 2010-09-06 2010-09-08 Recording
4 Record lead guitar Chris 2010-09-07 2010-09-09 Recording

fcp.gantt(df_basic, x=['Start', 'Stop'], y='Task', ax_size=[600, 400])
../_images/plot_types_gantt_12_0.png

As with other plots, tick label fonts, sizes, and rotations can all be controlled using the correct kwarg. See Grids and ticks for more details.

Grouping#

Like all other plots in fivecentplots, Gantt charts can grouped in various ways to provide further insight into the data set. This includes:

  • legend

  • row

  • col

  • wrap

keyword options. A couple of examples are shown below.

Legends#

Legends can be used to further distinguish various tasks by assignee or other factors. If the same task has multiple assignees, they will be split into two different bars in the chart.


fcp.gantt(df_basic, x=['Start', 'Stop'], y='Task', legend='Assigned', ax_size=[600, 400], gantt_tick_labels_x_rotation=45)
../_images/plot_types_gantt_18_0.png

When using a legend, we can also sort the y-axis values based on the order in the legend using keyword order_by_legend=True:


fcp.gantt(df_basic, x=['Start', 'Stop'], y='Task', legend='Assigned', ax_size=[600, 400], gantt_tick_labels_x_rotation=45, order_by_legend=True)

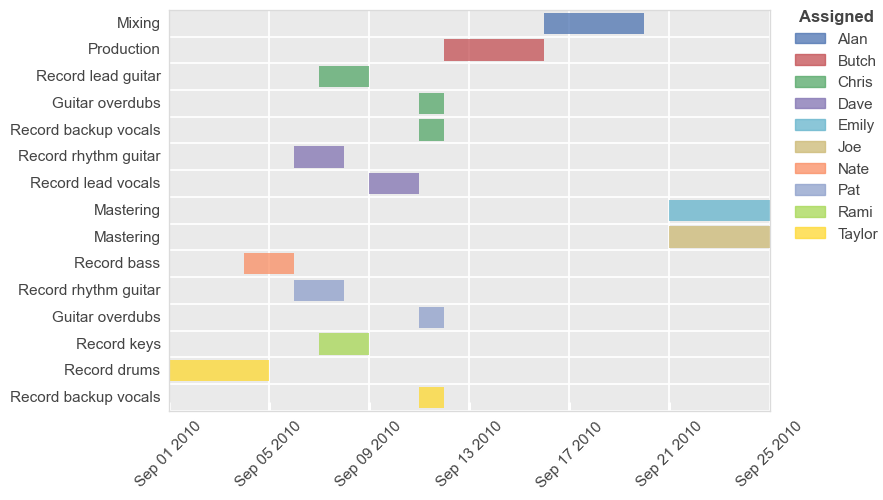

../_images/plot_types_gantt_20_0.png

Row/column plot#

Row grouping (share_y is automatically disabled):

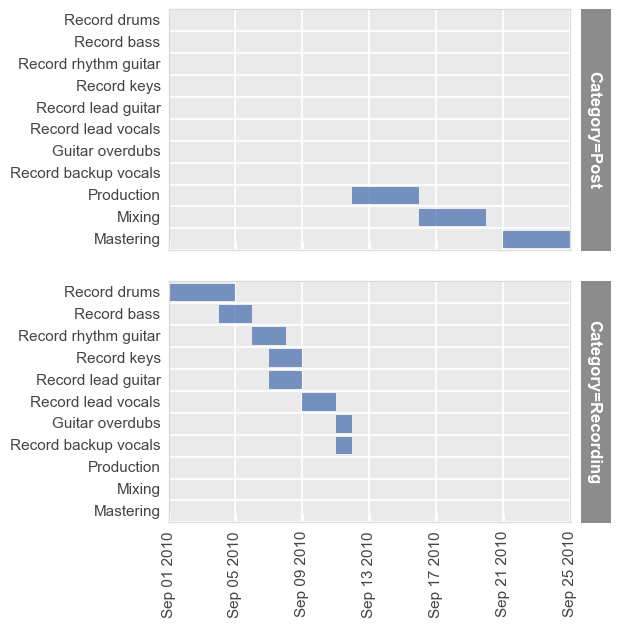

fcp.gantt(df_basic, x=['Start', 'Stop'], y='Task', row='Category', ax_size=[400, 240])
../_images/plot_types_gantt_23_0.png

Column grouping (share_y is automatically disabled):

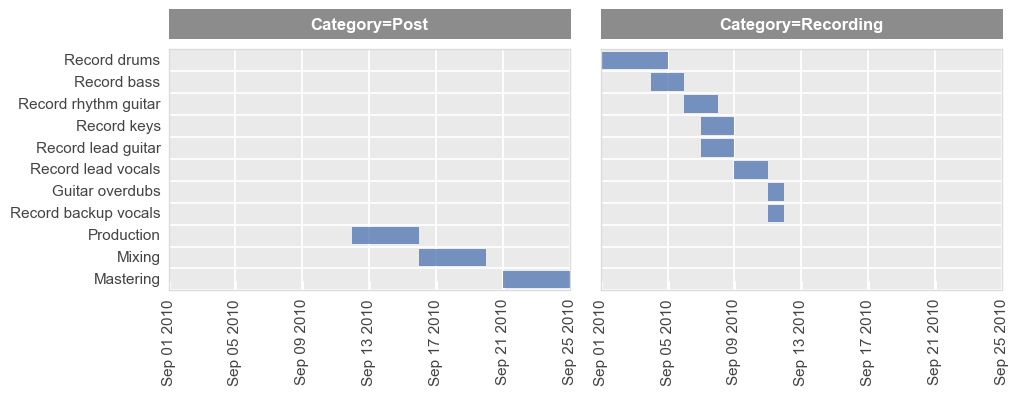

fcp.gantt(df_basic, x=['Start', 'Stop'], y='Task', col='Category', ax_size=[400, 240])
../_images/plot_types_gantt_25_0.png

Wrap plot#

Notice that share_y is enabled for this type of grouping:

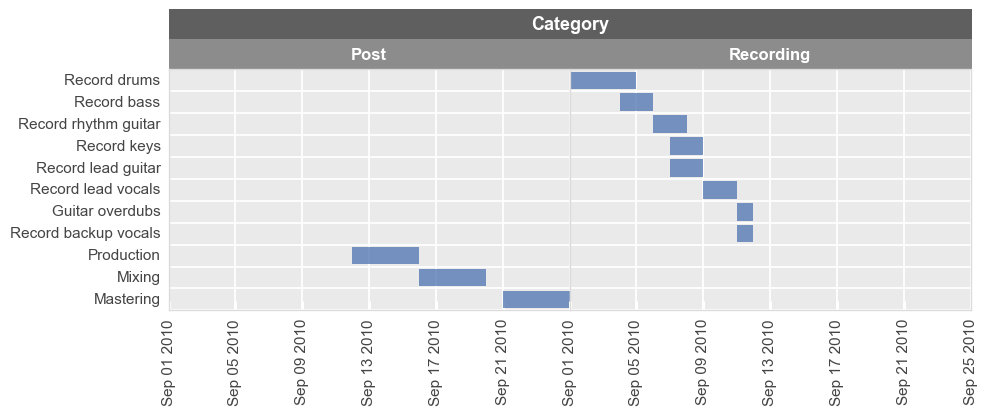

fcp.gantt(df_basic, x=['Start', 'Stop'], y='Task', wrap='Category', ax_size=[400, 240])
../_images/plot_types_gantt_28_0.png

Better Gantts#

While the basic Gantt chart works for displaying simple task lists, Gantt charts can be more powerful when they graphically show dependencies, group by user workstreams, denote milestones, and provide better date range demarcation. As of v0.6, fivecentplots provides these updated features when using the matplotlib engine.

First, load a new data set with a richer set of project details:


df = pd.read_csv(Path(fcp.__file__).parent / 'test_data/fake_data_gantt_milestone.csv')
df.head()

Quarter Priority Workstream Description Owner Jira Epic Start date End date Duration Milestone Dependency
0 2025-Q1 P0 Design Pixel layout Gary Garrison CRP-1013 01-01-2025 NaN 2w NaN NaN
1 2025-Q1 P0 Design Periphery circuits Andy Anderson CRP-1013 01-20-2025 03-31-2025 NaN NaN Pixel layout
2 2025-Q1 P1 Design TCAD simulation Sam Samuelson CRP-1013 02-22-2025 NaN 10d NaN NaN
3 2025-Q1 P2 Design Initial tape out Amber Amberly CRP-1013 02-22-2025 03-15-2025 NaN NaN NaN
4 2025-Q2 P0 Design Finalize tape out Amber Amberly CRP-1013 NaN NaN 1.5m NaN Pixel layout; Periphery circuits

Most keywords used for advanced Gannt chart creation support both a long and short form. The short-form is ideal for ad-hoc plot creation, but the long-form, which simply prepends the keyword with gantt_ could be useful to avoid keyword collisions within custom theme files.

  • Short-form example: workstreams_location

  • Long-form example: gantt_workstreams_location

Dates#

All Gantt charts in fivecentplots require a starting date and and ending date. However, several options are provided for viewing these ranges within the plot:

  • Basic:

    • simple string at each x-tick mark

    • by default, the tick label is rotated 90 degrees

    • date label tick range automatically determined based on the xmin to xmax range

    • date_location can be at the top or bottom of the plot (“bottom” by default)


fcp.gantt(df, x=['Start date', 'End date'], y='Description',
          xmin=datetime.datetime(2025, 2, 1), xmax=datetime.datetime(2025, 3, 31),
          workstreams='Workstream', ax_size=[900, 400])

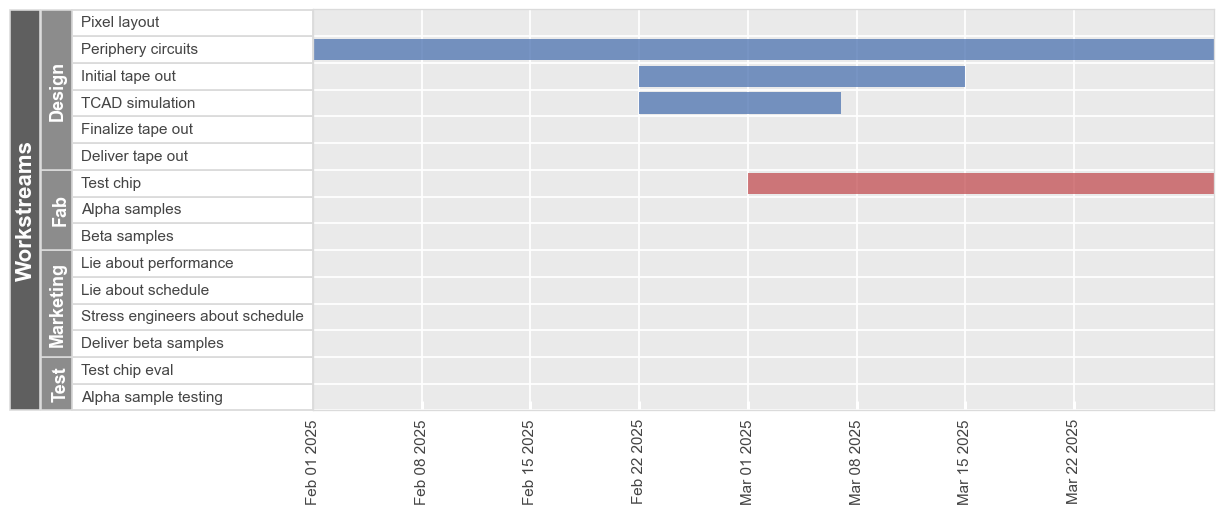

../_images/plot_types_gantt_35_0.png
  • Date range labels:

    • specified using keyword date_type (or gantt_date_type)

    • add a series of rectangular labels that span specific date ranges

    • can combine one more more unique label periods

    • date_location is always on top of the plot

    • options include: ‘year’, ‘quarter’, ‘month’, ‘week’, ‘quarter-year’, ‘month-year’


fcp.gantt(df, x=['Start date', 'End date'], y='Description',
          date_type='month-year',
          xmin=datetime.datetime(2025, 2, 1), xmax=datetime.datetime(2025, 10, 7),
          workstreams='Workstream', ax_size=[900, 400])

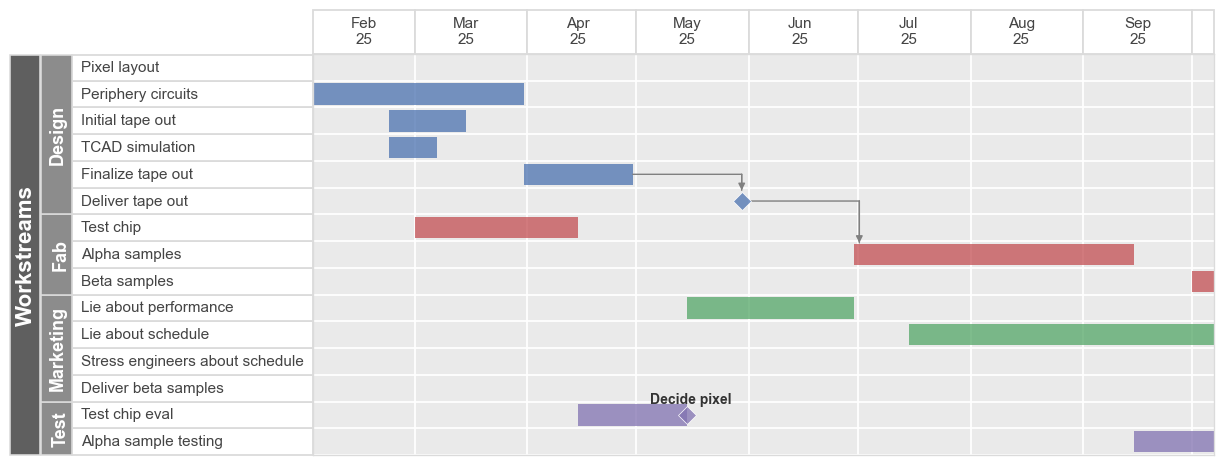

../_images/plot_types_gantt_37_0.png

fcp.gantt(df, x=['Start date', 'End date'], y='Description',
          date_type=['year', 'quarter', 'month', 'week'],
          xmin=datetime.datetime(2025, 2, 1),
          xmax=datetime.datetime(2025, 6, 1),
          workstreams='Workstream', ax_size=[900, 400])

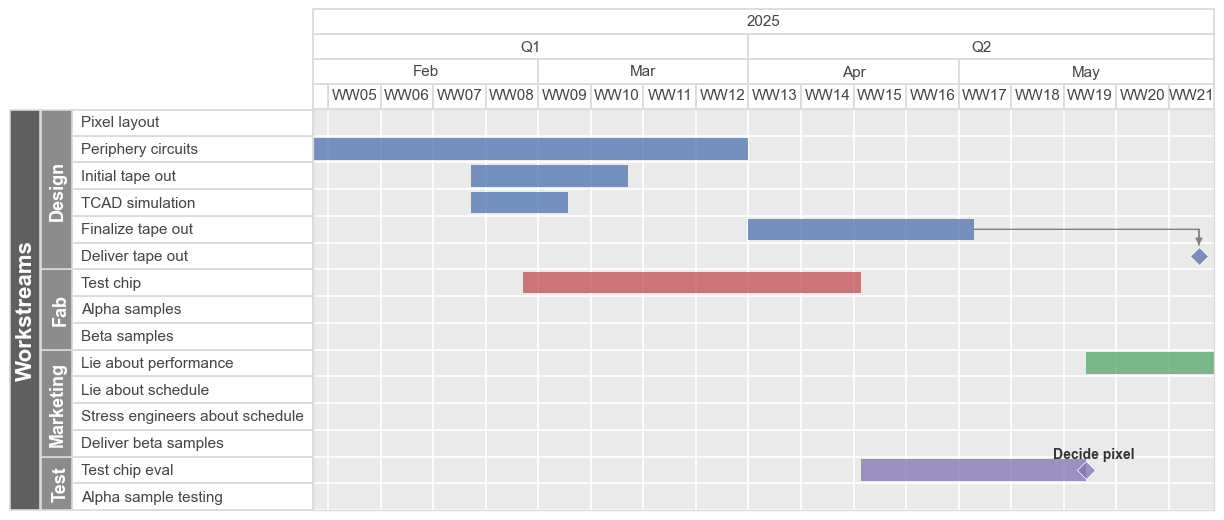

../_images/plot_types_gantt_38_0.png

Duration#

As mentioned above, all entries in a Gannt chart require a start and end date. For convenience, fivecentplots allows you to specify a start date and duration in lieu of an actual end date. Consider the first entry in our example chart:


df.loc[0:0]

Quarter Priority Workstream Description Owner Jira Epic Start date End date Duration Milestone Dependency
0 2025-Q1 P0 Design Pixel layout Gary Garrison CRP-1013 01-01-2025 NaN 2w NaN NaN

No specific end date is listed, but the “Duration” column indicates a task time of “2w” or two weeks. fivecentplots computes the actual end date and plots accordingly:


fcp.gantt(df, x=['Start date', 'End date'], y='Description',
          filter='Workstream=="Design"', ax_size=[900, 400])

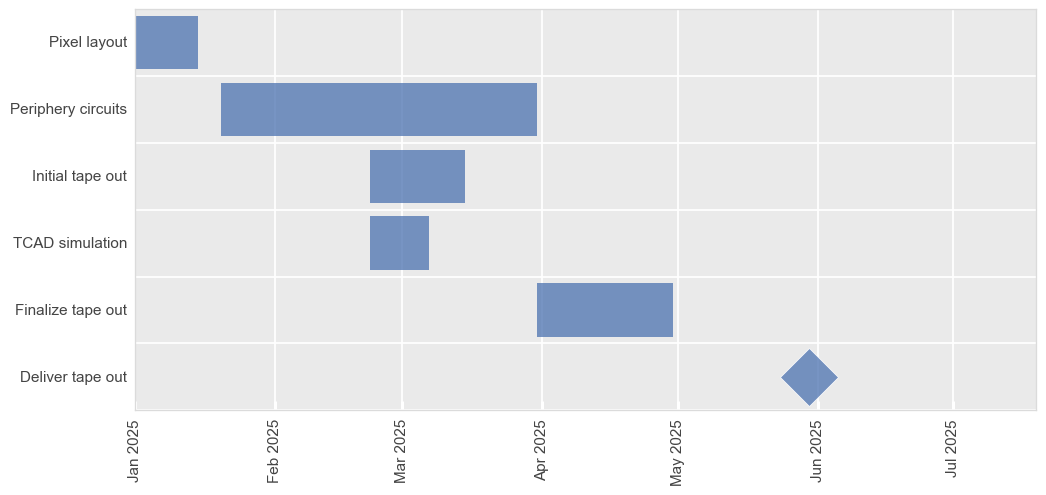

../_images/plot_types_gantt_43_0.png

The following durations are supported:

  • 'w' = weeks

    • can be an integer or a fraction (ex: '1.5w')

    • assumes full weeks of 7 days and does not account for weekends

  • 'm' = months

    • can be an integer or a fraction (ex: '2.2m')

    • assumes a month is 30 days and does not account for weekends

  • 'd' = days

    • only integers allowed

    • assumes only actual business days (disable with business_days=False)

    • assumes no work on US holidays (disable with us_holidays=False)

Workstreams#

A “workstream” is a group of related tasks within an overall project. Workstream values are specified within a column of the DataFrame similar to how legend values are specified, meaning each row of data that is part of a given workstream has a common value within a column that is identified using the kwarg workstreams. By default, workstream label values and the workstreams title will appear to the left of the Gantt chart with formatting similar to that of a wrap plot.


fcp.gantt(df, x=['Start date', 'End date'], y='Description', gantt_date_type=['quarter-year', 'month'],
          workstreams='Workstream', ax_size=[900, 400])
../_images/plot_types_gantt_47_0.png

Font and color properties of the workstreams labels and titles are accessible using workstreams_label_xxx or workstreams_title_xxx, respectively. An additional shortcut is provided, if you want to match the workstreams labels with the bar color; set match_bar_color=True


fcp.gantt(df, x=['Start date', 'End date'], y='Description', gantt_date_type=['quarter-year', 'month'],
          workstreams='Workstream', ax_size=[900, 400], match_bar_color=True)
../_images/plot_types_gantt_49_0.png

Additionally, keyword workstreams_location can set the position of the labels on the left (see above), right, or inline (see below). When using the inline location, workstreams_brackets which display the full duration of all tasks in the workstream and workstreams_highlight_row which colors the workstream title row are automatically enabled.

Note

When workstream labels and titles are used in place of y-tick labels, automatic removal of overlapping tick labels is disabled. If you change font sizes of these elements, you may also need to change the vertical height of your plot to accommodate the increased size as shown below


fcp.gantt(df, x=['Start date', 'End date'], y='Description', gantt_date_type=['quarter-year', 'month'],
          workstreams='Workstream', workstreams_location='inline', ax_size=[900, 800],
          workstreams_label_font_size=16, workstreams_label_font_style='italic',
          workstreams_title_font_size=20, workstreams_title_font_weight='bold')
../_images/plot_types_gantt_52_0.png

Today#

Besides being the greatest day Billy Corgan has ever known, “today” can be shown on the Gantt chart:


fcp.gantt(df, x=['Start date', 'End date'], y='Description', gantt_date_type=['quarter-year', 'month'],
          workstreams='Workstream', ax_size=[900, 400], today=True)

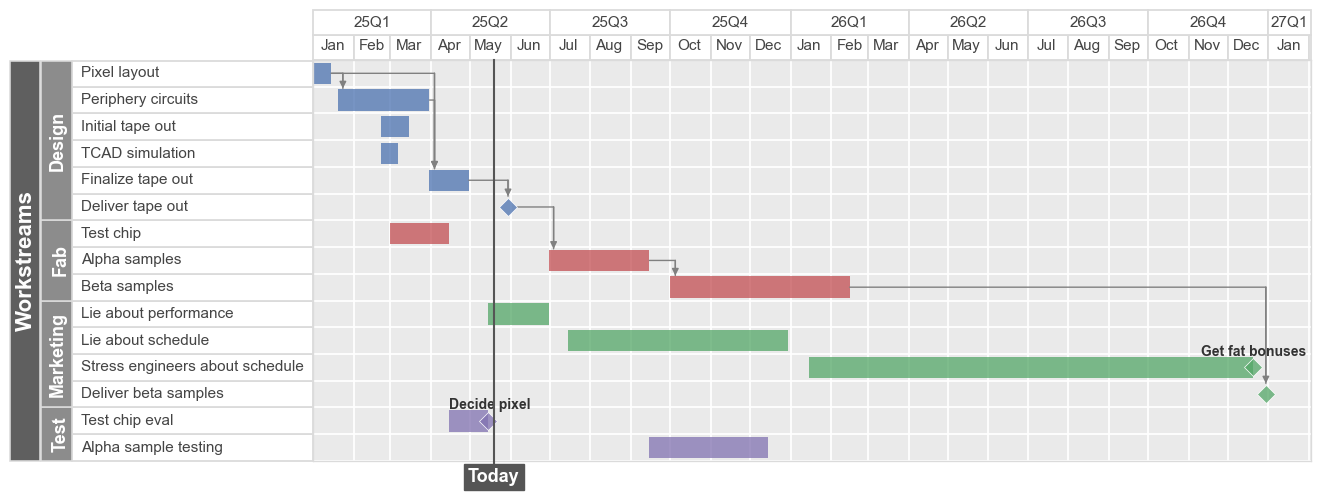

../_images/plot_types_gantt_55_0.png

By default, the today line and label elements will be placed according to datetime.datetime.now(). This can be customized using keywords beginning with today_. Lastly, the today label will always appear on the opposite side of the dates.


fcp.gantt(df, x=['Start date', 'End date'], y='Description',
          workstreams='Workstream', ax_size=[900, 400],
          today=datetime.datetime(2026, 1, 1), today_style='--', today_color='#FF0000',
          today_fill_color='#00AABB', today_edge_color='#FF0000', today_text='Happy New Year!',
          today_font='Comic Sans MS', today_font_size=20, today_font_weight='bold')

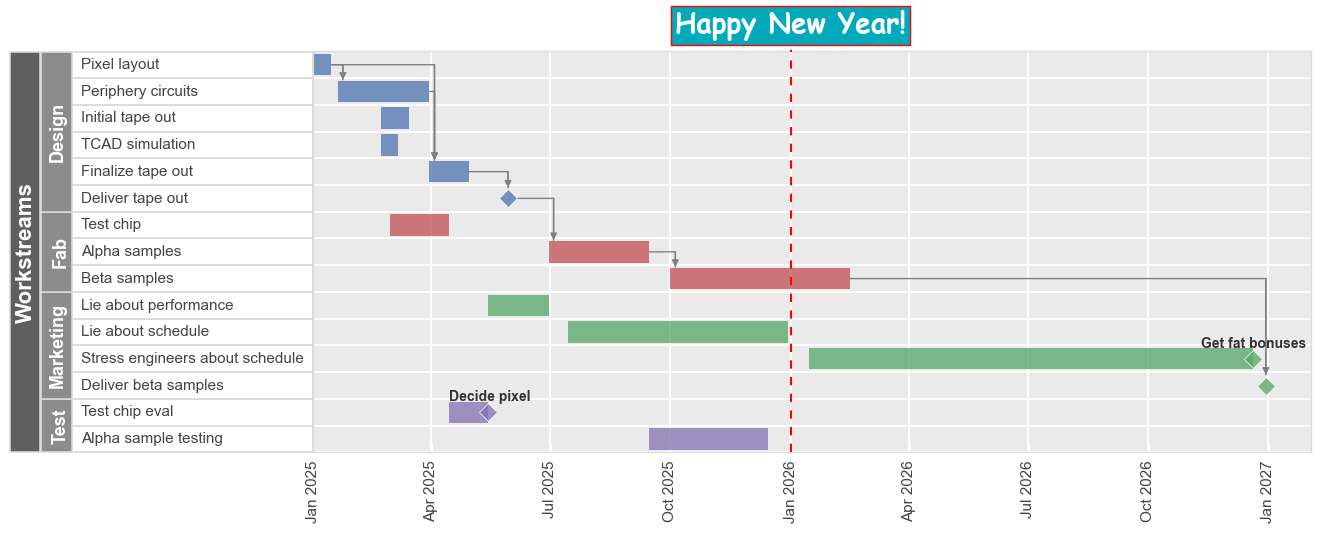

../_images/plot_types_gantt_57_0.png

Bar labels#

It is often convenient to display labels at the end of each bar on the Gantt chart which convey additional information about the task at hand. This can be accomplished by passing one or more column names from the DataFrame into keyword bar_labels:


fcp.gantt(df, x=['Start date', 'End date'], y='Description',
          bar_labels=['Owner', 'Jira Epic'],
          gantt_date_type=['quarter-year', 'month'], workstreams='Workstream', ax_size=[900, 400])
../_images/plot_types_gantt_60_0.png

Note

The Gantt chart width will automatically increase to accommodate the width of the bar labels, unless you have specified a value for xmin or xmax

Milestones#

A “milestone” is a special point in time with zero duration (i.e., start date = end date) and are rendered on the Gantt chart as diamonds. Any item in the DataFrame with a start date and no end date or duration is treated as a milestone. If an additional column of milestone labels is provided, an accompanying label is added adjacent to the diamond. For our example, there are 3 milestones (rows, 5, 10, 15), but only 2 have a label (rows 10, 15):


df[['Description', 'Start date', 'End date', 'Duration', 'Milestone']]

Description Start date End date Duration Milestone
0 Pixel layout 01-01-2025 NaN 2w NaN
1 Periphery circuits 01-20-2025 03-31-2025 NaN NaN
2 TCAD simulation 02-22-2025 NaN 10d NaN
3 Initial tape out 02-22-2025 03-15-2025 NaN NaN
4 Finalize tape out NaN NaN 1.5m NaN
5 Deliver tape out 05-30-2025 NaN NaN NaN
6 Test chip 03-01-2025 04-15-2025 NaN NaN
7 Alpha samples 06-30-2025 09-15-2025 NaN NaN
8 Beta samples 10-01-2025 02-15-2026 NaN NaN
9 Test chip eval 04-15-2025 05-15-2025 NaN NaN
10 Test chip eval 05-15-2025 NaN NaN Decide pixel
11 Alpha sample testing 09-15-2025 12-15-2025 NaN NaN
12 Lie about performance 05-15-2025 06-30-2025 NaN NaN
13 Lie about schedule 07-15-2025 12-30-2025 NaN NaN
14 Stress engineers about schedule 01-15-2026 12-20-2026 NaN NaN
15 Stress engineers about schedule 12-20-2026 NaN NaN Get fat bonuses
16 Deliver beta samples 12-30-2026 NaN NaN NaN

fcp.gantt(df, x=['Start date', 'End date'], y='Description', milestones=False,
          gantt_date_type=['quarter-year', 'month'], workstreams='Workstream', ax_size=[900, 400])

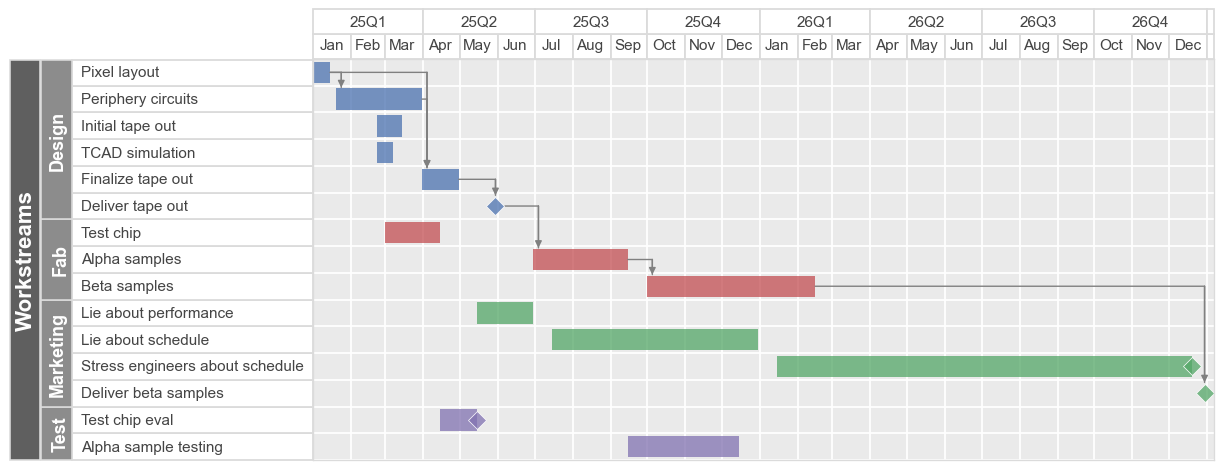

../_images/plot_types_gantt_65_0.png

Dependencies#

Dependencies between tasks can be visually indicated using arrows between the end of the first task to the start of the dependent task. This is accomplished by specifying one or more test in a “Dependency” column within the DataFrame. If the dependent task has multiple predecessors, separate them by a semicolon in the proper cell (see row 4 below):


df[['Description', 'Dependency']]

Description Dependency
0 Pixel layout NaN
1 Periphery circuits Pixel layout
2 TCAD simulation NaN
3 Initial tape out NaN
4 Finalize tape out Pixel layout; Periphery circuits
5 Deliver tape out Finalize tape out
6 Test chip NaN
7 Alpha samples Deliver tape out
8 Beta samples Alpha samples
9 Test chip eval NaN
10 Test chip eval NaN
11 Alpha sample testing NaN
12 Lie about performance NaN
13 Lie about schedule NaN
14 Stress engineers about schedule NaN
15 Stress engineers about schedule NaN
16 Deliver beta samples Beta samples

fivecentplots automatically checks for a column named “Dependency” but this can be overriden using keyword dependencies (or gantt_dependencies). Alternatively, these lines can be disabled by setting this column name to False:


fcp.gantt(df, x=['Start date', 'End date'], y='Description', dependencies=False,
          gantt_date_type=['quarter-year', 'month'], workstreams='Workstream', ax_size=[900, 400])

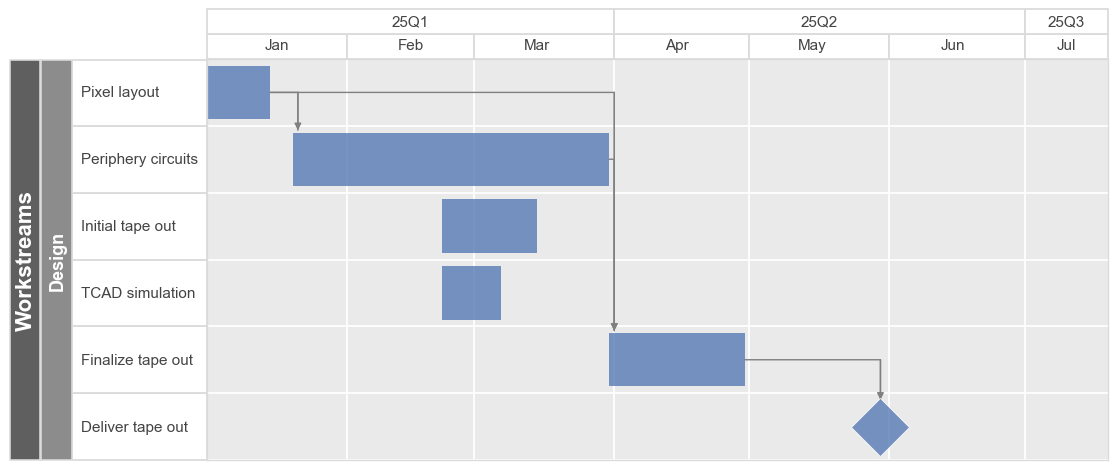

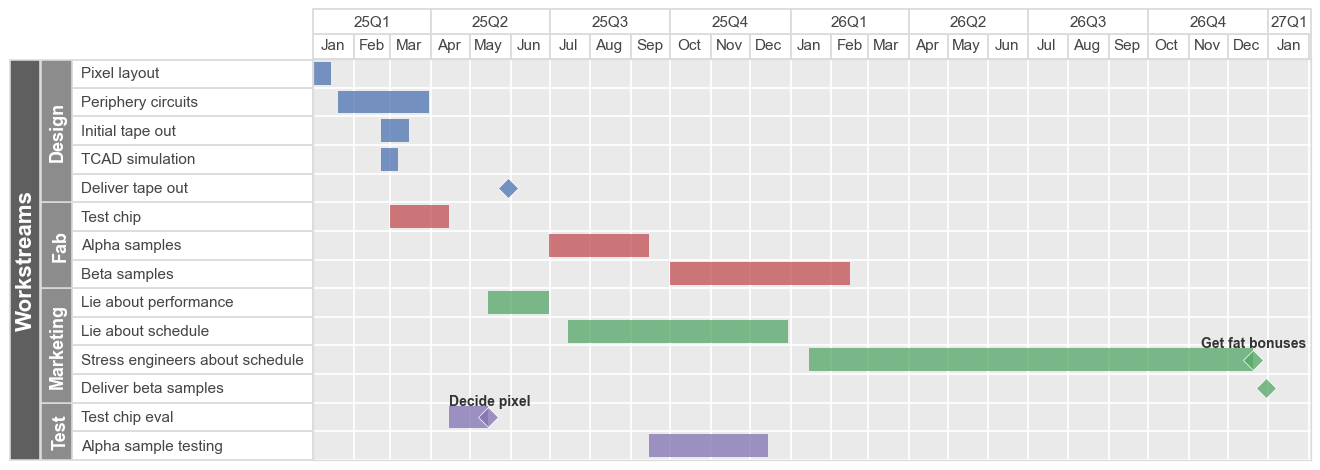

../_images/plot_types_gantt_70_0.png

When linking dependent tasks, it is permissible to leave the dependent tasks “Start date” cell empty. fivecentplots will automatically determine this date based on the end date of the predecessor tasks. In our example chart, “Finalize tape out” depends on both “Pixel layout” and “Periphery circuits”. “Pixel layout” finishes before “Periphery circuits” so in the actual plot we see that the start date of “Finalize tape out” matches the end date of that row:


df.loc[[0, 1, 4], ['Description', 'Start date', 'End date', 'Duration', 'Dependency']]

Description Start date End date Duration Dependency
0 Pixel layout 01-01-2025 NaN 2w NaN
1 Periphery circuits 01-20-2025 03-31-2025 NaN Pixel layout
4 Finalize tape out NaN NaN 1.5m Pixel layout; Periphery circuits

fcp.gantt(df, x=['Start date', 'End date'], y='Description',
          filter='Workstream=="Design"',
          gantt_date_type=['quarter-year', 'month'], workstreams='Workstream', ax_size=[900, 400])
../_images/plot_types_gantt_73_0.png

Styling#

Various style options are available for the Gantt bars themselves (note that gantt_height is a relative height where a value of 1 means it fills the full height between tick marks):


fcp.gantt(df_basic, x=['Start', 'Stop'], y='Task', ax_size=[600, 400], color_by='bar',
          gantt_edge_width=2, gantt_edge_color='#555555', gantt_height=0.2,
          gantt_fill_alpha=1)

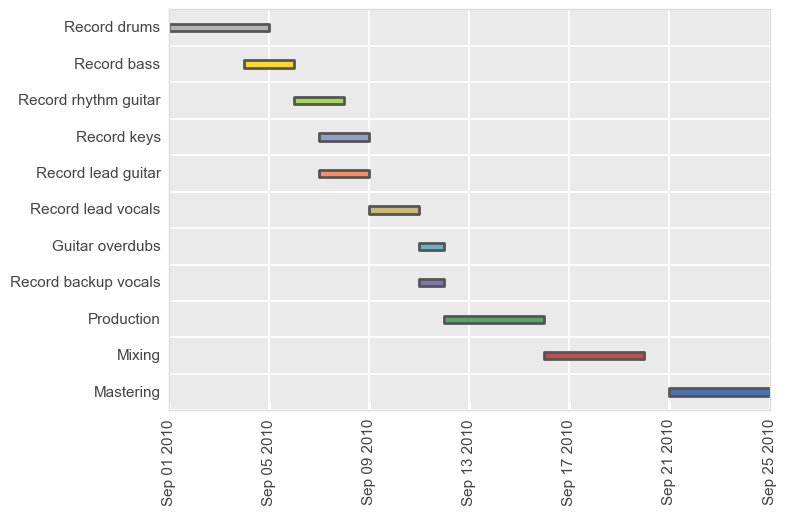

../_images/plot_types_gantt_76_0.png

Sorting#

By default, the sorting order of tasks is “descending” from top to bottom by date. We can flip that behavior with the keyword sort='ascending':


fcp.gantt(df_basic, x=['Start', 'Stop'], y='Task', sort='ascending', ax_size=[600, 400])

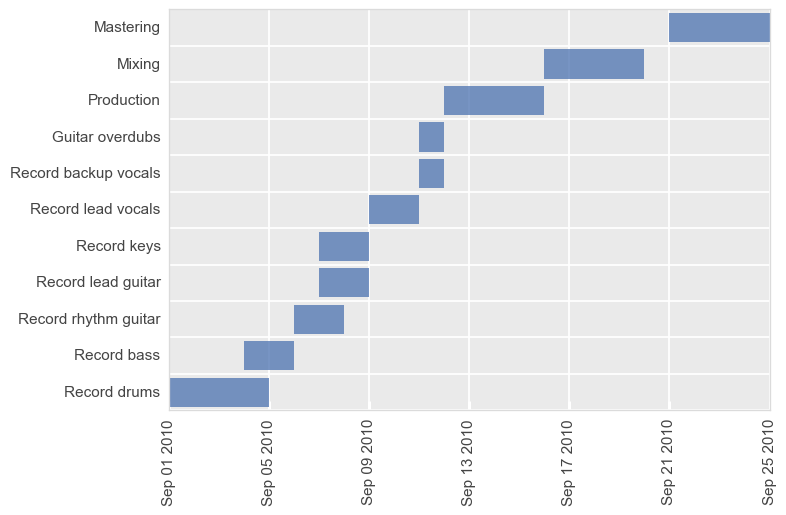

../_images/plot_types_gantt_79_0.png
